As of September 30, 2022, Osisko Development has produced 19,874 ounces of gold ("Au") from its three projects.
Tintic Project (Utah, USA) Highlights:
- 5,353 ounces of gold produced at an average grade of 0.91 ounces per ton ("oz/t") Au (31.3 grams per tonne ("g/t") Au) since the date of Osisko Development’s acquisition ("Acquisition") of Tintic on May 27, 2022.
- 2,613 tonnes processed via vat leaching on site in the third quarter of 2022 ("Q3 2022").
- 1,342 feet (409 meters) of portal and ramp construction complete (~25% complete).
- 20,000 feet (6,096 metres) of reverse circulation ("RC") drilling and 1,898 ft. (622 metres) of diamond drilling since the date of the Acquisition, and four drill rigs currently in operation.
Cariboo Project (BC, Canada) Highlights:
- 7,163 ounces of gold produced at an average grade of 6.50 g/t Au from Bonanza Ledge Test Mine in 2022 from 53,352 tonnes of mineralized material milled.
- Final documents for the Cariboo Gold Project Environmental Assessment filed and under final review by the provincial government.
San Antonio Project (Sonora, Mexico) Highlights:
- 7,358 ounces of gold sold from the San Antonio heap leach pad in 2022.
- 1 million tonnes at an average grade of 0.58 g/t Au have been placed on the heap leach pad.

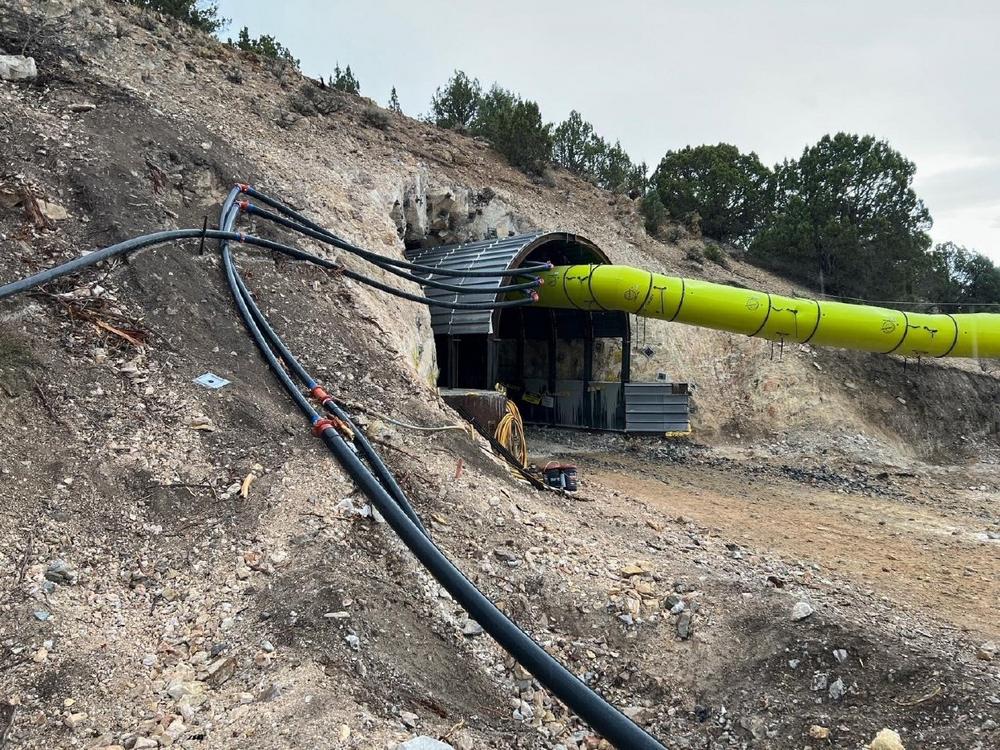

Tintic Project (Utah, USA)
Osisko Development completed its Acquisition of the Tintic project on May 27, 2022 and has since focused on the following objectives:
- Defining an initial mineral resource estimate, in compliance with National Instrument 43-101 – Standards of Disclosure for Mineral Projects ("NI 43-101") by the first quarter of 2023 to support near term mine planning and production.
- Increasing production following the completion of a decline ramp to improve access to Trixie by the third quarter of 2023.
- Generating new exploration targets and opportunities through historic data compilation.
The Operational Highlights are discussed below:
- 5,353 oz of gold produced and sold since the Company completed its Acquisition of Tintic on May 27, 2022 at an average grade of 0.91 oz/t Au (31.3 g/t Au). Mineralized material comes from blended T4 and T2 zones encountered during underground exploration development.
- 78% gold recoveries and completion of an on-site tails holding pad, currently in the process of being permitted for heap leaching.
- Four rigs in operation (two underground diamond drills and two surface RC drill rigs).
- 20,000 feet (6,096 metres) of RC drilling and 1,898 ft. (642 m) of diamond drilling completed since the completion of the Assay results are pending for this drilling.
- Continuous underground mine face and back sampling of T2 and T4. This information, together with the diamond drill results, will form the basis of the initial mineral resource estimate.
- 1,007 feet (307 metres) of advancement in third quarter of 2022 along the Trixie portal and decline, which is now approximately 25% complete. Once fully complete, the decline will significantly improve access to the underground workings, expand and increase underground exploration areas and activities, and is expected to be the principal access for future larger scale mining on the T2 and T4 zones. Development of this decline will continue to the lower levels of Trixie, which was historically mined to 1,350 feet (412 metres) below surface with many stopes ending in mineralization.
- 3,239 feet (987 metres) of underground development on or near the 625 level of Trixie along strike of the T2 and T4 mineralized zones including exploration crosscuts driven orthogonal to the east of the T2 and T4 zones, and 465 feet (142 metres) of raises excavated. This excludes production stoping completed in the T2 mineralized zone.
- The on strike and depth limits of both the T2 high grade structure and the adjacent T4 and 75/85 zones are still yet undefined. This could potentially indicate growth potential for this part of the Trixie mine.
- Construction of a new sample prep facility in the on-site assay laboratory and improvements in process to maintain proficiency in quality assurance and quality control ("QA/QC") complete with an external lab audit.
- Ongoing historical data compilation to generate exploration targets along strike of and within historic mine areas.
The Company recently launched a 3D model of the Tintic Project on the Vrify platform. This 3D presentation guides the viewer through the Trixie Project, geologic model, and historic and current underground development. It also gives an in-depth view of our surface infrastructure, including an on-site assay laboratory, processing and vat leach plant and rock sample library. Lastly, it gives a preview of our future exploration plans and opportunities. Photos of the new ramp are also presented below.
Click Link below to view Vrify 3D Tintic Model:
Regional Exploration Update
The Tintic District is the second most prolific historic metal producer in Utah and the East Tintic District is the least explored land package within the wider Tintic District with all 23 past producing mines in the East Tintic District not outcropping and concealed and preserved by horst – graben development Basin and Range tectonic event.
Regional Exploration Data integration and interpretation is defining new epithermal gold targets as well as several new polymetallic carbonate replacement and porphyry targets. Since taking on the project, Osisko Development, outside of the Trixie Mine area, has already identified two new gold targets and two porphyry targets with potential to drill over the next 24 months.
Trixie Update
The Trixie mine is one of several gold and base metal targets within the larger Tintic Project consisting of 17,000 acres of patented and mineral leases within the historic Tintic Mining District of Central Utah. The T2 and T4 structures at Trixie show multi ounce gold grades associated with high sulphidation alteration hosted within quartzites. High grade mineralized material from the T2 and T4 structures is being processed via vat leaching on site. Table 1 summarizes the key operational details that were accomplished at Trixie in the month of June as compared with Q3 2022.
Cariboo Gold Project (BC, Canada)
The Cariboo Gold Project is in advanced stages of permitting and economic studies, as summarized in the following highlights:
- The Feasibility Study ("FS") for the Cariboo Gold project is scheduled to be completed before the end of the 2022 calendar year. The FS is being designed to account for the current inflationary environment and will contemplate a staged, lower capital intensity project with scalable infrastructure. This approach to developing the Cariboo Project will mitigate capital intensity risk while also maximizing our margins as well as our ability to exploit what we anticipate to be multiple deposits over two trends totalling approximately 80 km of mineralization, with the ultimate goal of establishing a large mining camp.
- Signing Ceremony on October 23, 2022 with Lhtako Dene First Nation’s Elders and Members in Wells and Quesnel was an important event for the life of project agreement between Lhtako Dene First Nation and Osisko Development highlighting the importance of our partnership and mutual support and benefits.
- The Revised Application for the Environmental Assessment ("EA") Process was submitted to the Environmental Assessment Office of British Columbia (the "EAO") on October 14, 2022 for the Cariboo Gold Project. The 1,700 comments received by the different reviewers were successfully addressed and the Company is expecting the official acceptance by the Ministry of Energy Mines and Low Carbon Innovation (the "Ministry") by mid-November 2022 to proceed to the Affect Assessment & Recommendations, which is the last phase of the Environment Assessment process. This aligns with the Company’s expected timeline to receive the EA Certificate in first quarter of 2023 for an operational capacity of 4,750 tonnes / day.
- In parallel to the EA process, the Company initiated an official application for the permitting of the Cariboo Gold Project with the submission of the Project Description to the Ministry on September 30, 2022. The Company expects to receive final permits in fourth quarter of 2023.
- All drilling and geologic modeling work has been completed and 2022 assay results will be released upon final QA/QC controls shortly.
- Outside of the Cariboo Gold Project area there are 25 high quality drill-ready targets demonstrating the years of ongoing exploration in the mineral rights held by the Company around the Cariboo Gold Project.
The Cariboo Project is Osisko Development’s flagship asset with a measured mineral resource of 9 k oz of Au (47 Kt grading 5.1 g/t), an indicated mineral resources of 3.46 M oz of Au (27.1 Mt grading 4.0 g/t Au) and an inferred mineral resource of 1.62 M oz of Au (14.4 Mt grading 3.5 g/t Au). See Company news release dated May 24, 2022. The total land package of 155,000 hectares and approximately 80 kilometers strike of mineral targets, providing prospective opportunities for future discoveries (Figure 3).
Information outlined above uses the terms measured, indicated, and inferred mineral resources as a relative measure of the level of confidence in the resource estimate. Readers are cautioned that mineral resources are not economic mineral reserves and that the economic viability of mineral resources that are not mineral reserves has not been demonstrated. The estimate of mineral resources may be materially affected by geology, environmental, permitting, legal, title, socio-political, marketing, or other relevant issues. It cannot be assumed that all or any part of an inferred mineral resource will ever be upgraded to an indicated or measured mineral resource category. The mineral resource estimate is classified in accordance with the Canadian Institute of Mining, Metallurgy and Petroleum’s "CIM Definition Standards on Mineral Resources and Mineral Reserves" incorporated by reference into NI 43-101. Under Canadian rules, estimates of inferred mineral resources may not form the basis of feasibility or pre-feasibility studies or economic studies except for a preliminary economic assessment as defined under NI 43-101. Readers are cautioned not to assume that further work on the stated resources will lead to mineral reserves that can be mined economically. Readers are cautioned that the Cariboo Technical Report (as defined below), being a preliminary economic assessment (within the meaning of NI 43-101), is preliminary in nature and includes inferred mineral resources that are considered too speculative geologically to have economic consideration applied to them that would enable them to be categorized as mineral reserves. There is no certainty that the preliminary economic assessment (within the meaning of NI 43-101) will be realized.
San Antonio Project
Highlights from the San Antonio 2022 work program are as follows:
- 1,062,864 tonnes from stockpile placed on heap leach pad, with an average grade of 0.58 g/t Au and 0.25 g/t silver ("Ag") for an estimated total of 20,090 oz of Au and 8,818 oz of Ag. The gold grades were slightly higher than the original estimated 0.57 g/t prior to placement on the leach pad.
- 10,149 oz of Au and 3,516 oz of Ag at recoveries to the end of the third quarter of 2022 of 50.5% for gold and 39.9% for silver total production from heap leach pad as of October 27, 2022.
The San Antonio Gold Project, located in the state of Sonora, Mexico, includes five known deposits and at least a dozen other gold exploration targets over 11,338 hectares. A recent mineral resource estimate (see news release dated June 30, 2022) includes 576,000 oz of Au and 1.37 million ounces of Ag (14.9 million tonnes grading 1.2 g/t Au and 2.9 g/t Ag) in the indicated mineral resource category and 544,000 ounces of gold and 1.76 million ounces of silver (16.6 million tonnes grading 1.0 g/t Au and 3.3 g/t Ag) in the inferred mineral resource category. The San Antonio Project gold mineralization is characterized by hydrothermal breccia that forms an approximately 3,000 metres long east-northeast trending mineralization corridor with the Luz del Cobre copper deposit at the east.
San Antonio Expected Impairment
The Company has assessed the carrying value of its assets as at September 30, 2022 as part of its financial results preparation and currently believes that its financial statements for the three and nine months ended September 30, 2022 will recognize an asset impairment in respect of the San Antonio Project.
The expected impairment charge is a result primarily of industry cost pressures and the current inflationary environment, which resulted in an increase in interest rates and thus the risk-free rate underpinning the applicable weighted average cost of capital used in the impairment assessment.
The expected asset impairment is a non-cash item and, for the avoidance of doubt, will have no impact on cashflows. Furthermore, the expected asset impairment is not expected to have any impact on Osisko Development’s mine plans, gold reserves and resources, and streaming and royalty agreements. This assessment for impairment has been undertaken in accordance with the relevant accounting standards and related solely to the San Antonio Project.
The amount of the asset impairment to be recognized in the financial statements for the three and nine months ended September 30, 2022 has not been finalized.
Sean Roosen, Chairman and CEO of Osisko Development commented:
"Osisko Development offers a unique opportunity through three advanced brownfield projects, which have all produced gold this year. Tintic, located in Utah, is fully permitted and producing gold from small scale mining while a larger ramp is 25% complete, which we anticipate will allow for larger scale mining. Tintic offers immediate production and a host of prospective exploration opportunities to shareholders and stakeholders while the other two projects complete the permitting cycle.
The Cariboo Project, which comprises over 383,000 acres and a 50-mile mineralized trend, is currently in the permitting process and the Environmental Assessment has been filed for a 4,750 tonne per day mine capacity.
The San Antonio Project has completed stacking of 1.1 million tonnes of mineralized material on a heap leach pad with active leaching anticipated for the next 90 to 120 days. Management is currently evaluating its options for the project.
At Osisko Development, we are extremely proud of the portfolio we have built. All three projects are in strong mining jurisdictions, offer brownfield infrastructure and have camp-scale exploration potential. We continue to advance through permitting at Cariboo and anticipate to ramp-up our production and exploration activities at Tintic."
Qualified Persons
David Sabourin, P.E., Chief Operating Officer of Tintic Consolidated Metals, and a "qualified person" for purposes of NI 43-101, has reviewed and approved the technical and scientific content in this news release relating to the Tintic Project. All operational and information provided in this update is documented and stored in the Company database.
François Vézina, ing., P.Eng., MBA, Senior Vice President of Technical Services for Osisko Development, and a "qualified person" for purposes of NI 43-101, has reviewed and approved the technical and scientific content in this news release relating to the San Antonio gold project.
Maggie Layman, P.Geo, Vice President of Exploration for Osisko Development, and a "qualified person" for purposes of NI 43-101, has reviewed and approved the technical and scientific content in this news release relating to Cariboo Gold Project.
Technical Reports
Information relating to the Tintic Project is supported by the technical report titled "Technical Report on the Tintic Project, East Tintic Mining District, Utah County, Utah, USA", dated June 10, 2022 (with an effective date of June 7, 2022) prepared for the Company by Dr. Thomas A. Henricksen, QP, C.P.G. (the "Tintic Technical Report"). Reference should be made to the full text of the Tintic Technical Report, which was prepared in accordance with NI 43-101 and is available electronically on SEDAR (www.sedar.com) under Osisko Development’s issuer profile.
Information relating to the Cariboo Gold Project is supported by the technical report titled "NI 43-101 Technical Report, Preliminary Economic Assessment for the Cariboo Gold Project, District of Wells, British Columbia, Canada", dated June 22, 2022 (with an effective date of May 24, 2022) prepared for the Company by representatives of BBA Engineering Ltd., InnovExplo Inc., SRK Consulting (Canada) Inc., WSP Canada Inc. (WSP Golder), WSP USA Inc. (WSP Golder), Klohn Crippen Berger and Falkirk Environmental Consultants Ltd. (the "Cariboo Technical Report"). Reference should be made to the full text of the Cariboo Technical Report, which was prepared in accordance with NI 43-101 and is available electronically on SEDAR (www.sedar.com) under Osisko Development’s issuer profile.
Information relating to the San Antonio Project is supported by the technical report titled "NI 43-101 Technical Report for the 2022 Mineral Resource Estimate on the San Antonio Project, Sonora, Mexico", dated July 12, 2022 (with an effective Date of June 24, 2022) prepared for the Company by Micon International Limited (the "San Antonio Technical Report"). Reference should be made to the full text of the San Antonio Technical Report, which was prepared in accordance with NI 43-101 and is available electronically on SEDAR (www.sedar.com) under Osisko Development’s issuer profile.
