Adventus and Salazar Announce Purchase of Construction Camp Facilities for El Domo Project and Provide Status Update on Feasibility Study Activities

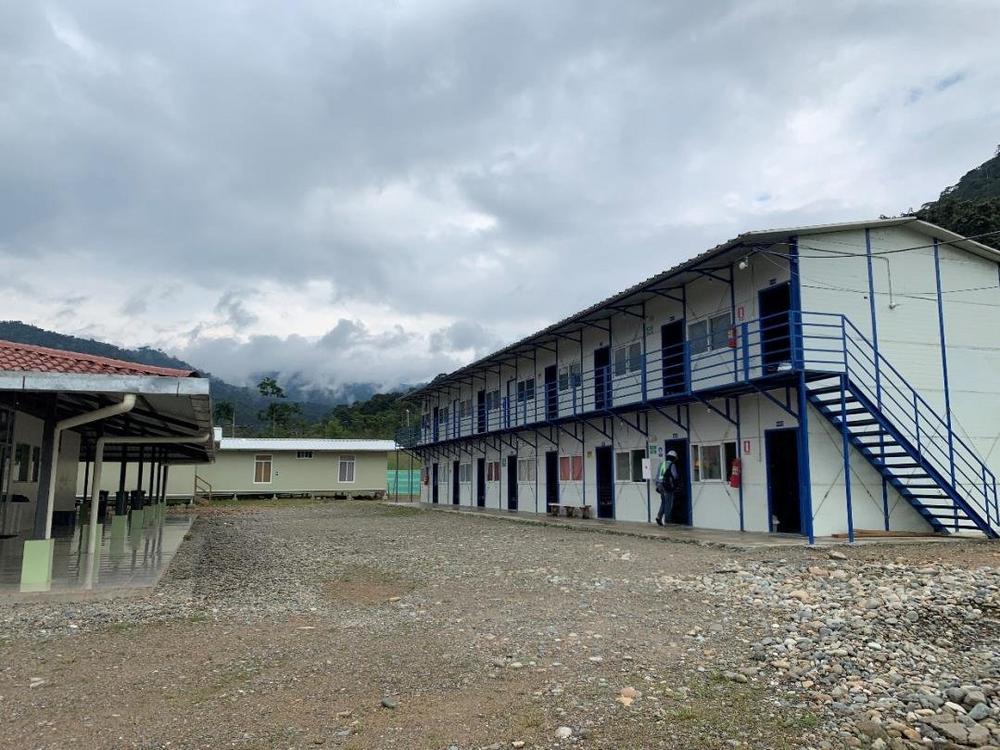

Adventus Mining Corporation (“Adventus”) (TSX-V: ADZN; OTCQX: ADVZF) and Salazar Resources Limited ("Salazar") (TSX-V: SRL) (collectively the "Partners" – https://www.commodity-tv.com/ondemand/companies/profil/adventus-mining-corp/ ) are pleased to announce that a binding letter of intent has been issued for the purchase of a worker housing facility for the future construction of the El Domo project in Ecuador.

In anticipation of the El Domo feasibility study completion in the fourth quarter of 2021 (the “Feasibility Study”), the Partners are continuing to advance detailed planning for the final engineering design and mine construction commencement beginning in 2022. The opportunity to advance-purchase construction camp facilities aligns with the El Domo development strategy and will provide housing for personnel during the construction and commissioning phases of the mine. The camp is a previously-owned facility, having most recently been used for the construction of a bridge near the Fruta del Norte mine in southeastern Ecuador.

The El Domo Feasibility Study continues to progress on budget and on schedule for completion in the fourth quarter of 2021. Adventus’ Vice President of Projects, Dustin Small, commented, “We are very encouraged by the work completed on the Feasibility Study to date, and look forward to sharing the final results later this year. We are putting in significant effort now to enable Adventus to be in a position to immediately proceed with the execution phase of the project upon successful completion of the study.”

Following finalization of the purchase contract expected in July, the camp facilities will be disassembled and warehoused in Quito until such time as it is required for the construction of the mine. The labour strategy for the construction phase of the project is to maximize the employment of skills and labour in the communities surrounding the El Domo deposit and greater Curipamba project area in central Ecuador. This approach was chosen to develop and support the local economy, and also provides logistical benefits to the project such as minimizing the camp size required to house non-local members of the workforce.

Following are some highlights of the work completed on the Feasibility Study to date:

  • Environment & Social Impact Assessment (“ESIA”) contract awarded – The contract to prepare the ESIA for the project has been awarded to Ecuadorian environmental engineering consultant Cardno Entrix, who have been involved in the only three large scale mining ESIAs Ecuador to date. Work on the ESIA commenced in June and is expected to be completed in September for submission to the government of Ecuador. As the primary permitting requirement for the project, this is a major step towards our ability to begin construction in 2022.
  • Community consultations – In May, the first round of official community consultations were held about the upcoming construction and operational phases of the El Domo project, with a second consultation planned shortly. The first consultation was very well attended by over 300 community members in 11 different communities, and it was confirmed that employment opportunities and water management are the two most important topics from those who were in attendance.
  • Mineral Resource estimate update – An update to the mineral resource estimate is currently underway and is expected to be completed in July. This will allow finalization of the Feasibility Study life of mine plan, the maiden estimate of Mineral Reserves, and the open pit design. With this engineering work in hand, final mine fleet size will be determined, and the Partners will engage with mining contractors who have affirmed interest for a long term mining contract for life of mine operations.
  • Metallurgical test work program nearing completion – The Feasibility Study metallurgical test work program has been underway since February and is anticipated to be completed in August. The latest program is focused on variability test work and confirmation of metallurgical performance using fresh ore from the recently completed infill drilling program at El Domo.
  • Process plant design is complete – The process plant design proceeded in parallel with the metallurgical test work program and is now complete. Based on the test work results to date, it is very unlikely that any significant changes will be required. The facility is expected to have a design throughput capacity of 1,850 tonnes per day, and will be designed to produce three payable concentrates – copper, zinc, and lead.
  • Mine site infrastructure – The majority of mine site infrastructure layout has been completed, including the access road, haul roads, administration facilities, maintenance shops, warehousing, and power distribution system. Work on the tailings facility and surface water management facilities is in progress, which is expected to be completed in August.
  • Early contractor engagement program – The Partners have engaged with several well-established Ecuadorian construction contractors to involve them early in the project, who in turn have provided extremely strong support by means of cost estimation, constructability reviews, labour/workforce strategy, and execution planning. Establishing these relationships early will help to streamline the transition from study to construction while also providing more certainty on both cost and schedule estimates for the Feasibility Study.
  • Geotechnical drilling complete – All geotechnical drilling for the Feasibility Study has been completed, and the results are being used in the engineering design. No further drilling is required to complete the Feasibility Study.
  • Execution plan development – A detailed project execution plan is under development that goes beyond the typical requirements for the Feasibility Study. The Partners are taking this approach to allow for a quick transition into execution once the Feasibility Study is complete and a construction decision is approved by the Adventus board. The Partners also intend to implement a detailed operational readiness program to ensure preparedness for eventual mine operations.
